Re-open Ashington Blyth & Tyne Line


SENRUG’s 2008 Charter Train at Newcastle - John Brierley

What Is Proposed?

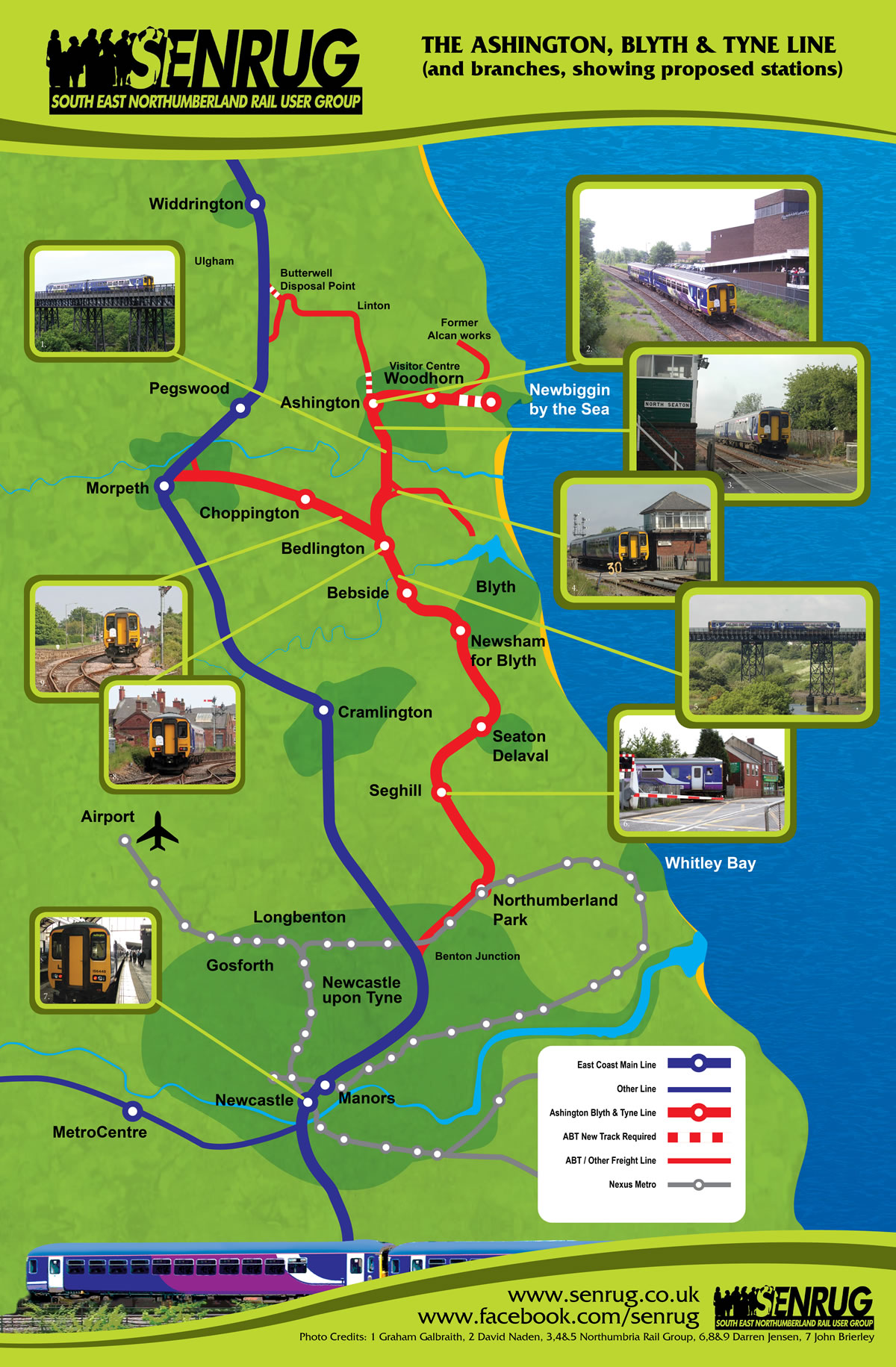

Re-introduction of passenger services on the fully operational and maintained freight line between Newcastle and Ashington, with intermediate stations at Northumberland Park (Metro Connection), Seghill, Seaton Delaval, Newsham for Blyth, Bebside and Bedlington.

Beyond Ashington, the working freight line continues and passes alongside the Woodhorn Museum of Mining and Northumberland Life, a major tourist attraction in the region. A station adjacent to the museum would serve as a Park & Ride facility for commuters from the outlying villages of Newbiggin by the Sea, Linton, Lynemouth and Ellington, as well as creating an off-peak demand for visitors to the Museum.

Blyth would be served by stations at Newsham, on the outskirts of the town, and the station at Bebside.

Why?

South East Northumberland is a former mining area which suffered economically with the closure of the mines and has never fully recovered. Unemployment rates are significantly above the national average and the area is economically depressed with many of the jobs that do exist being part time and / or at minimum wage levels.

Re-opening the Ashington Blyth & Tyne line would regenerate region by providing access to employment in Newcastle and beyond, as well as places such as Cobalt Business Park served by the station at Northumberland Park. The line would connect areas of opportunity with areas of need.

Good transport connections including links to London, Leeds and Birmingham through connecting services at Newcastle would make the area more attractive for industry. People who already have jobs would find that Ashington and the other communities the line serves become attractive places to live due to easy commuting to Newcastle, and so would bring new money into the local economies.

SENRUG acknowledges that most households have access to a car; but in many households 2 or more people are looking for employment but there is only one car. Young people in particular can not normally afford their own transport and need good public transport links for work or college.

The line would essentially be a commuter railway and relieve growing road congestion on the A189 / A19 corridor. Additionally however the station at Woodhorn would create a leisure market and bringing visitors to the area from further afield, creating an off-peak flow which is a luxury few commuter lines enjoy.

How?

As this is a fully operational working freight line, re-introduction of passenger services should be quite straightforward and much easier than other re-opening campaigns where new track would need to be laid.

However, the southern section of the line is single track, and to achieve the service frequencies SENRUG believes would be optimum (30 minutes during peak hours and hourly outside peaks), a dynamic passing loop would need to be built somewhere near Seghill, allowing trains to pass without slowing down.

The former stations at Northumberland Park, Seghill, Seaton Delaval, Newsham for Blyth, Bebside, Bedlington and Ashington would need to be re-built. These would be low cost, unstaffed stations without station buildings. Both of the original platforms remain in tact at Ashington, as does the southbound platform at Bedlington (there never was a northbound platform at Bedlington). Northumberland Park is a working Metro station but a platform and overbridge would be needed for the Network Rail line. A new station would be needed at Woodhorn.

What’s Happened So Far?

SENRUG started campaigning for the re-opening of this line in 2004. Our understanding has always been that for the campaign to succeed, we need to have the sponsoring local authority (Northumberland County Council) fully on board and driving the scheme forward through the statutory channels.

Campaigning has been hard work, with a number of ups and downs, and the following chronology sets out the dates for key events – both positive and less so. For brevity, some events have been merged together and some dates are approximate.

However, Northumberland County Council are now driving the scheme forward through the Network Rail GRIP Process (Governance For Rail Investment Projects)

Mar 05 SENRUG put forward plans for phased re-opening.
Dec 05 Early Day Motion signed by all the region’s MPs
Jan 07 North East Assembly commissioned a report into Phase 1 of SENRUG’s proposals (extending Newcastle to Morpeth services on to Choppington and Bedlington)
Apr 07 Nexus asked same consultants to look at capacity for Northumberland Park to Ashington
May 07 SENRUG organised online petition to 10 Downing Street which attracted over 1,000 signatures.
Jun 07 Adjournment Debate held at Westminster.
Jul 07 Denis Murphy former MP for Wansbeck and SENRUG Chair Dennis Fancett meet Rail Minister Tom Harris
May 08 Northumberland County Council (NCC) launched GRIP 4 study with freight operator (freight operator subsequently canceled it).
Jun 08 SENRUG organised charter train to Ashington. The train made 3 return trips during the day. Tickets on the 2nd and 3rd trip were sold to members of the public, but the first trip was reserved for invited stakeholders only including MP, MEP, Councillors and officers from various local authorities, Business Leaders, TUC and the Press. There were just under 1 special guests on the stakeholder trip, and the event was covered on the radio and TV local news and TV The Politics Show

Jul 08 Rail Minister Tom Harris receives presentation from SENRUG Chair Dennis Fancett at Woodhorn
Mar 09 Secretary of State Geoff Hoon visits the scheme. SENRUG Chair Dennis Fancett presents the scheme to him again at Woodhorn.

Photo acknowledgement: The Journal
Jun 09 ATOC (The Association of Train Operating Companies) includes scheme in its “Connecting Communities” Report. Now there is support from within the rail industry.
Nov 10 NCC (Northumberland County Council) commence revision of its Local Transport Plan and list the scheme as it’s top priority.
Mar 10 SENRUG hosts “hustings” meetings with parliamentary candidates for Wansbeck for the forthcoming general election. All support the scheme
Jun 11 NCC commission Market Appraisal report to meet new DfT (Department For Transport) requirements.
Nov 11 Closure of Alcan Smelter announced – but Network Rail say freight on the line still expected to increase.
Dec 11 NCC receives Market Appraisal report and proceeds with Demand Assessment Report from AECOM
May 12 AECOM Demand Assessment Report submitted to NCC
Aug 12 NCC, AECOM &SENRUG present Demand Assessment Report to DfT, then tour the line and station sites.
Aug 12 DfT advise NCC to proceed with GRIP 3 study from Network Rail as quickly as possible.
Oct 12 NCC Executive Member for Transport & Infrastructure Simon Reed gives upbeat message at SENRUG public meeting, confirming the Council’s commitment to press ahead with the scheme.
Mar 13 NCC advise SENRUG they will be proceeding to GRIP 3 after completion of preparatory work.
Jun 13 NCC announce formal study into re-opening the line. NCC tell SENRUG Network Rail are now unable to carry out the GRIP Stages 1-3 concurrently so this will be a GRIP 1 Study initially, but it will be fast-tracked.
Nov 13 NCC tell SENRUG Network Rail can not after all fastrack the GRIP 1 Study but that it will be completed by January 14
Jan 14 NCC say GRIP 1 Study from Network Rail now expected end March 14
Mar 14 NCC say GRIP 1 Study now received from Network Rail and they have a programme of work to move forward.
Apr 14 SENRUG announce a Schools Competition for local schools to produce a DVD setting out the business case for re-opening the line. 5 local schools will participate. The winning entry will be presented to the schools’ MP at parliament to commemorate the 50th anniversary of the line’s closure in November 1964. For more details go to http://www.senrug.co.uk/2014SchoolsCompetition.php
May 14 NCC organise Stakeholder Meeting to present GRIP 1 Report from Network Rail and discuss options for moving forward
Nov 14 Northumberland County Council announces they have set aside £20m for the scheme. This will cover the cost of the GRIP 2 & 3 study from Network Rail, the GRIP 4 study after that, and include a significant contribution towards the final re-opening costs.
Dec 14 Following announcement of the winners of the Schools DVD competition in September 14, SENRUG Chair Dennis Fancett takes the winning team from Hirst Park Middle School in Ashington to London to present their DVD to Ian Lavery MP for Wansbeck. Mr Lavery says the DVD is of excellent quality and re-iterates his full support for the re-opening. For more details and to see the winning entries go to http://www.senrug.co.uk/2014SchoolsCompetition.php
Feb 15 Northumberland County Council full budget approved; this includes the money set aside for the GRIP 2 and 3 study from Network Rail. SENRUG understands the Council will now sign the GRIP 2 and 3 contract with Network Rail.
Oct 15 Northumberland County Council announce they are proceeding with the GRIP 2 Study from Network Rail and that it is scheduled for completion by June or July 2016.
May 16 Northumberland County Council ask SENRUG to provide a letter of support for their bid for funding to proceed on to the Network Rail GRIP 3 Study – and SENRUG readily agrees.
Jun 16 Northumberland County Council receive GRIP 2 report back from Network Rail – but without some key financial data that is to follow.
Jul 16 North East Combined Authority publishes “ METROFUTURES - The combined future of Metro and local rail in the North East”. This document shows that a local rail route will be established to Ashington via the existing heavy rail freight route as per the SENRUG campaign (and not via the longer Metro route between Newcastle and Northumberland Park). However the document is widely mis-reported in both local TV and press as a proposed Metro extension to Ashington. Correspondence between Chair of SENRUG and Director of Rail at NECA confirms the plan remains exactly as the SENRUG campaign, although greater integration of heavy rail and metro, with a physical connection between the 2 systems at Northumberland Park is envisaged.
Sep 16 Northumberland County Council receive full GRIP 2 Report from Network Rail, and seek internal approval to proceed to GRIP 3. GRIP 2 estimates re-opening costs at £191m, but this includes a 40% contingency for things like signalling upgrades which must be done whether passenger services are re-introduced or not. Excluding these, SENRUG estimates the true cost for re-introducing passenger trains is nearer to the £50m it has consistently estimated. The Council indicate they hope to commissioning the GRIP 3 by December 2016, the GRIP 4 by October 2018, start construction by February 2019 with trains running by 2021! SENRUG applauds this positive schedule but notes the GRIP 1 and 2 reports both took longer to commission and longer to complete than scheduled, and trusts further delays will be eliminated as the project gains momentum.
Oct 16 Northumberland County Council announce they are proceeding with the GRIP 3 Study from Network Rail. This means staff are authorised to negotiate terms and price with Network Rail, not that a contract has been signed for Network Rail to do the work
May 17 Northumberland Local Council Elections. Conservatives take control though 1 seat short of overall majority
Jun 17 Tories confirm they are committed to the re-opening and say it is there number 1 priority
Nov 17 NCC asks Network Rail for an interim study – dubbed GRIP 2B - - to see if both costs for the GRIP 3 and the full re-opening can be reduced and process speeded up if some functionality is missed at initially
Nov 17 Re-opening Ashington Blyth & Tyne Line specifically mentioned in government statement “A Strategic Vision For Rail”
Feb 18 The Chief Economist to the Bank of England visits Ashington, and blogs his hunch is the benefits of re-opening the railway would be “whopper”. See his blog here.
May 18 GRIP 2B completed by Network Rail but does not offer anticipated cost savings. NCC say they are still committed to progressing

After The Line is Re-Opened, What Then?

Once the core link is re-opened, that will not be the end of the campaign. The route has lots of further potential and SENRUG will continue to campaign for the following:

- Creation of stations at both Seaton Delaval and Seghill if they are not included in the core re-opening scheme.

- Introduction of a service between Morpeth and Bedlington with an intermediate station at Choppington. This can be achieved by extending the MetroCentre to Morpeth local services on to Choppington and Bedlington.

- A link between Blyth Town Centre and Newsham. Whilst the original passenger line has been built over in a few places, SENRUG has identified the former freight route Blyth Port could be used for this, terminating closer to where the Town centre is today, and with an intermediate station where the trackbed passes Cowpen Road.

- Extension from Woodhorn to Newbiggin by the Sea. This would require re-instatement of quarter of a mile of new track along the former track bed, from a point where the existing working freight route swings north, just east of the A189 Spine Road.

- There is a privately owned working freight line from Ashington running north to the Butterwell works, rejoining the East Coast Main Line at Stobswood. SENRUG believes the route of this line should be protected, so that after freight operations cease at the end of opencast mining, it could be used to connect the northern end of the Ashington Blyth and Tyne line to the East Coast Main Line, creating extra capacity for local services between Newcastle and Alnwick. However, the proposal would require re-instatement of the recently severed link joining the privately owned line to the Network Rail line north of Ashington (fairly straightforward) and the re-alignment of the junction at Stobswood so it joins the East Coast Main Line facing north. This would be more complex given the vertical separation, but could be achieved whilst heavy earth moving equipment is on site as used for the opencast mining operations.
